Sardothien Investments
Vauxhall Cross Island Costings
Please complete all fields below to access this document.
Investment Report Confidential

Vauxhall Cross Island
Deployment & Project Mobilisation Report

Initial Development and Project Mobilisation Budget — £15.0 Million | Three-Tranche Release Programme
Project: Vauxhall Cross Island Location: London SW8, Zone 1 Date: July 2026 Classification: INVESTMENT CEO CONFIDENTIAL
Close-up of the Vauxhall Cross Island tower facade with the Thames, Big Ben and the London skyline in the background.

1. Executive Summary

The proposed investment structure is based on an investor entering into an MOU covering a total £200 million investment commitment in return for a 40% equity interest in the agreed Vauxhall Cross Island project-holding structure. Once the MOU is signed for the £200 million acquisition, the £15 million Deployment & Project Mobilisation starts immediately.

Planning permission for the site was approved in 2018. The lower-floor change of use for the data centre is the only additional planning work required. Repurposing the lower levels for the data centre can proceed under the existing 2018 consent while the change-of-use application is progressed in parallel.

The first funded component will be the £15 million Initial Development and Project Mobilisation Budget, released in three milestone-controlled tranches of £5 million. This initial capital will fund the legal, planning, architectural, engineering, commercial and project-delivery programme required to:

  • Protect and progress the acquisition
  • Update the 2017 design and technical work against the 2018 permission
  • Determine the planning route for repurposing lower floors as a data centre
  • Validate power, fibre, cooling, structural and operational requirements
  • Mobilise surveys, site investigations and lawful site-establishment works
  • Appoint the professional and contractor teams
  • Complete the project business plan, appraisal and cost plan
  • Commence hotel, data-centre and office/retail exit-partnership processes
  • Establish the conditions for release of the balance of the £200 million commitment

The £200 million investment commitment is divided between a £135 million proposed site-acquisition price, the £15 million Initial Development and Project Mobilisation Budget, and £50 million of development deployment. This sits within a wider £1.18 billion development programme incorporating residential, hotel, data-centre and commercial components. The £135 million acquisition price is separate from and is not included in the £15 million mobilisation budget detailed below.

Initial Development and Project Mobilisation Budget — £15.0 Million: The following figures are proposed project management allowances rather than consultant quotations. They are suitable for investor approval and tendering but will be replaced by negotiated appointments and fixed fee proposals wherever possible. The budget includes legal and transaction costs, design and planning, engineering, technical validation, surveys, project management, procurement, contractor pre-construction, statutory work, commercial partner engagement, limited enabling activity and contingency. It does not include the £135 million site-acquisition price or the £50 million development-deployment allocation.

£200M
Total Investor Commitment (MOU)
£135M
Acquisition
£50M
Development Deployment
£15M
Project Mobilisation
Aerial view of Vauxhall Cross Island within the wider Vauxhall Nine Elms Battersea (VNEB) Opportunity Area.
Vauxhall Cross Island in context — the 0.57-hectare island site at the heart of the Vauxhall transport interchange, within the £15B VNEB regeneration zone.

2. Investment Structure

ItemCommercial Position
Total investor commitment under MOU£200.0M
Initial development and project mobilisation£15.0M
Subsequent investment balance£185.0M
Proposed site-acquisition price£135.0M
Development deployment allocation£50.0M

Key Assumptions

  1. The £15 million is credited on a fully creditable basis against the investor's total £200 million commitment.
  2. The remaining £185 million is released subject to defined acquisition, technical, planning, governance and funding conditions.
  3. Dilution, future capital calls, development-finance priority and default remedies will be addressed in the definitive shareholders' and subscription agreements.

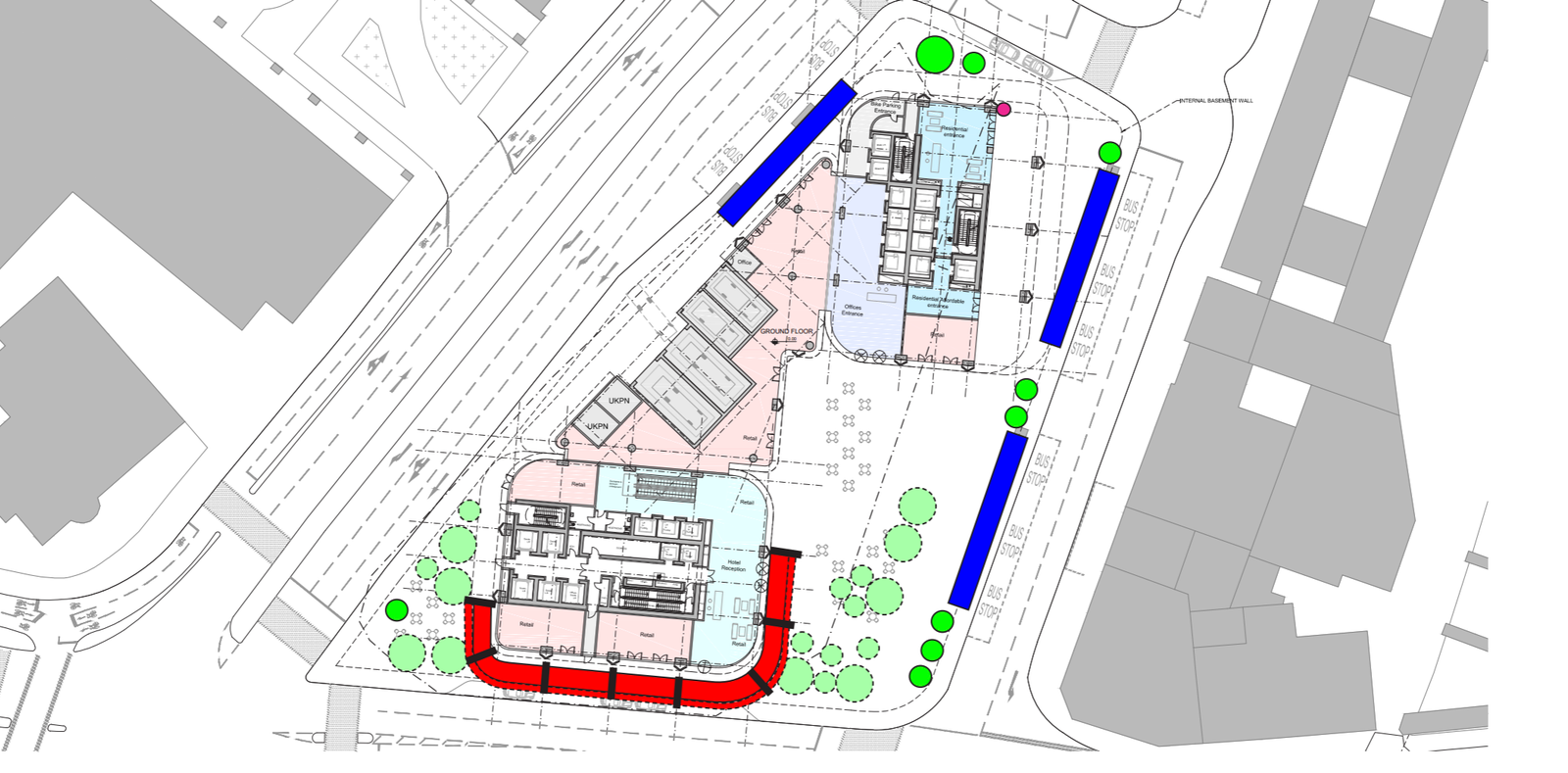

Ground floor plan of Vauxhall Cross Island.
Ground floor plan — retail, office, hotel reception, residential entrance, and data centre areas. The site is bounded by Wandsworth Road and the Vauxhall transport interchange.

3. Initial Development and Project Mobilisation Budget — £15.0 Million

The detailed use-of-funds section relates only to the £15 million Initial Development and Project Mobilisation Budget. It does not include the separate £135 million site-acquisition price. The following figures are proposed project management allowances rather than consultant quotations. They are suitable for investor approval and tendering but will be replaced by negotiated appointments and fixed fee proposals wherever possible.

3.1 Consolidated Budget

WorkstreamRevised AllocationDescription
Legal, transaction, tax and acquisition reserves£4.175MLegal and transaction fee, provisional duty reserve, tax and compliance, appraisal and historical introductory fee
Architecture, planning, engineering and QS£2.650MZaha Hadid Architects, Buro Happold, DP9, specialist planning advisers and quantity surveyor
Data-centre repurposing and technical validation£2.050MPower, fibre, data-centre concept design, structural integration and first-stage technical assessments
Site mobilisation, procurement and early works£2.800MSurveys, investigations, site protection, PCSA, procurement and statutory submissions
Sardothien project delivery and commercialisation£2.325MProject-management office, development management, capital coordination and operator engagement
Protected project buffer£1.000MRing-fenced contingency controlled through investor-approved governance
Total Initial Development and Mobilisation Budget£15.000MThree milestone-controlled tranches of £5 million
Street-level view of the Vauxhall Cross Island tower podium.
Street-level podium view — retail frontage, entrance canopies, and public realm designed by Zaha Hadid Architects.

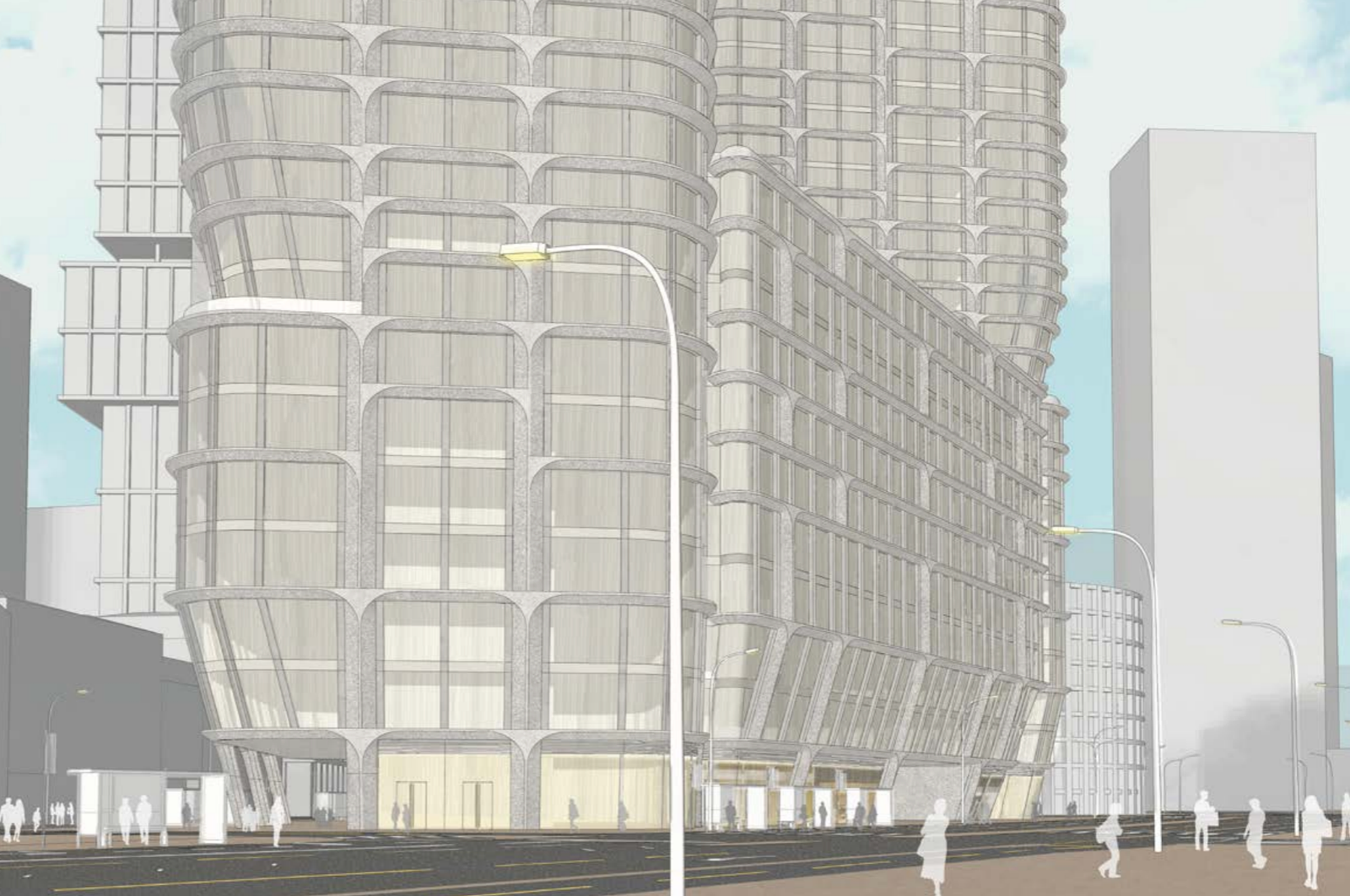

Close-up detail of the tower facade showing the distinctive curved balconies.
Facade detail — signature curved balconies and floor-to-ceiling glazing. Tower 1 rises to 185m (52 storeys); Tower 2 to 151m (46 storeys).

3.2 Transaction, Legal, Tax and Acquisition Reserves — £4.175M

Cost ItemRevised AllocationPurpose
Legal, transaction, structuring and acquisition advisory fees£2,700,0002% of the £135 million proposed acquisition price; payable only when the £15 million facility legally closes
Provisional stamp-duty reserve£675,000Provisional 0.5% reserve, subject to written UK/Jersey tax advice and final transaction structure
Tax, KYC, AML and compliance£150,000UK and Jersey tax coordination, beneficial ownership, source-of-funds and compliance work
Business planning and appraisal£150,000Integrated business plan, development appraisal, cash flow and sensitivity analysis
Historical introductory fee£500,000Payable only following facility close and satisfaction of the existing legal and governance controls
Subtotal£4,175,000

Stamp-Duty Qualification: The £675,000 figure is arithmetically correct: £135,000,000 × 0.5% = £675,000. However, it will be held as a provisional acquisition-tax reserve, not treated as a confirmed liability. 100% of the Jersey Vauxhall company (VCI Property Holding Limited) will be acquired, producing an estimated £18 million saving on stamp duty compared with a direct UK land transfer. VCI Property Holding Limited is a Jersey entity. A written UK/Jersey tax opinion must determine jurisdiction, execution location, and applicable duty. No part of the £675,000 reserve will be released before that opinion is completed.

Legal Fee — £2,700,000: The allowance may include: acquisition legal documentation; title and corporate due diligence; investor and shareholder agreements; acquisition and funding agreements; UK and Jersey structuring advice; planning and Section 106 review; security documentation; consultant and construction appointments; warranties and reliance documentation; and regulatory, sanctions, KYC, AML and source-of-funds coordination.

Historical Introductory Fee Controls: The £500,000 payment will be released only after: (i) the full £15 million facility has legally closed; (ii) KYC and sanctions checks completed; (iii) the underlying introduction agreement produced; (iv) correct invoicing; (v) tax treatment confirmed; (vi) conflicts declared; (vii) Board approval obtained; and (viii) legal advisers confirm the fee does not breach any agency, fiduciary or regulatory obligation.

4. Architecture, Planning, Engineering and QS Programme — £2.650M

The original Design and Access Statement was prepared in 2017. Planning permission for the site was approved in 2018. The consent covers a mixed-use residential, hotel, office and retail development. The original professional team includes Zaha Hadid Architects, Buro Happold, DP9, Core Five, Miller Hare, Tavernor Consultancy and GIA.

The current investment proposition introduces a 150,000 sq ft data centre as a major project component. The design, planning and technical work must reconcile the approved 2018 scheme with the proposed lower-floor repurposing. The scope is limited to design audit, feasibility, coordinated RIBA Stage 2 development, selected Stage 3 work only where required, and planning and investment-readiness work. It does not include completion of the entire 1.2 million sq ft development to full RIBA Stage 3 or Stage 4.

4.1 £2.5M Architecture, Planning & Engineering Allocation

Consultant or WorkstreamRevised AllocationRequired Scope
Zaha Hadid Architects£1,000,000Existing-design audit, lower-floor repurposing, test fits, spatial coordination and defined RIBA Stage 2 work
Buro Happold£750,000Structural, MEP, energy, fire, transport, sustainability and data-centre integration
DP9£350,000Planning audit, pre-application strategy, consent route, condition review and application management
Townscape and heritage£175,000Updated townscape, heritage, visual and London-view assessment work
Daylight, sunlight and rights of light£125,000Updated assessment reflecting revised internal uses and any relevant design changes
Landscape, access and transport coordination£100,000Public realm, servicing, access, pedestrian and TfL-interface review
Total£2,500,000

4.2 £150,000 Quantity-Surveyor Report

Core Five is identified as the original cost consultant. The QS report must include:

  • Reconciliation of the £135 million proposed site-acquisition price
  • Review of the £50 million development-deployment budget
  • Updated £700 million mixed-use construction cost plan
  • Separate £280 million data-centre cost plan
  • Elemental costs by asset class, London labour and logistics allowances
  • Inflation, escalation, contractor preliminaries, professional and statutory costs
  • Abnormals, remediation, basement and substructure risk
  • Data-centre equipment replacement and commissioning
  • Risk-adjusted out-turn forecast and monthly development cash flow
  • Procurement and packaging strategy
Interior view of a luxury apartment at Vauxhall Cross Island.
Luxury apartment interior — floor-to-ceiling curved glazing with panoramic Thames views. 600 units across both towers with an average 850 sq ft per unit.

5. Data-Centre Repurposing and Technical Validation — £2.050M

This workstream is separate from the £2.5 million architectural and planning allocation. It funds specialist studies, utility applications and technical validation required to confirm the data-centre feasibility and bankability of the lower-floor repurposing.

5.1 Specialist Package Breakdown

Specialist PackageRevised Allocation
Power and grid-connection strategy£350,000
Fibre and carrier-connectivity study£80,000
Data-centre concept, MEP and resilience design£550,000
Structural, fire, security, acoustic and logistics integration£250,000
Initial ground-risk and geo-environmental report£50,000
Cooling, water, energy, carbon and heat-reuse studies£270,000
Planning and environmental technical evidence£225,000
Independent constructability, programme and cost verification£175,000
Technical contingency£100,000
Total£2,050,000

5.2 Ground-Risk Assessment — £50,000

The £50,000 allowance covers an initial ground-risk, geological and geo-environmental assessment comprising: review of historic information, previous boreholes and investigations, contamination records, basement and foundation information, hydrogeological conditions, a site walkover, preliminary risk register and specification for any targeted subsequent intrusive investigation.

This amount is for the initial report and risk assessment only. Boreholes, extensive laboratory testing, groundwater monitoring and major intrusive investigations are not all included within this amount. Any required targeted intrusive work may be procured from the separate site-investigation allowance. The purpose is to avoid commissioning unnecessary investigation work before existing information has been reviewed.

5.3 Power Scope

The project identifies a 15–22.5MW requirement in proximity to MI6 grid infrastructure. The power package must establish: firm capacity; point of connection; voltage; available fault level; physical route; substation requirements; redundancy configuration (N, N+1, 2N); connection cost; reinforcement requirements; and realistic energisation date. UK Power Networks provides formal pre-application and connection-support routes. Proximity to infrastructure does not prove that grid capacity is available. Formal written confirmation of capacity, connection terms and energisation date must be obtained before the data-centre design can be finalised.

5.4 Data-Centre Operational Brief

Before the concept can be fixed, Sardothien must decide the asset positioning: hyperscale, colocation, enterprise, sovereign/high-security, powered shell, fully fitted turnkey, or forward-funded and operated by a third party. The design team must establish target IT capacity, rack density, cooling technology, liquid-cooling readiness, UPS and generator configuration, fire detection and suppression, security zoning, PUE and WUE targets, and certification pathway.

Certification Note: Any Tier III or Tier IV description will be treated as a design target until independently assessed and certified. Uptime Institute distinguishes between the Tier Standard, design-document certification and constructed-facility certification.

Dramatic dusk view of both Vauxhall Cross Island towers.
The completed development at dusk — the 150,000 sq ft data centre occupies dedicated podium and basement levels. Power and connectivity must be formally confirmed before design finalisation. £280M build cost, £600M GDV (£4,000/sq ft).

6. Site Mobilisation, Procurement and Early Works — £2.800M

All enabling works come under the build budget, not the Deployment & Project Mobilisation Budget. The £2.8 million allocation covers surveys, investigations, site protection, PCSA services, procurement and statutory submissions only.

6.1 Breakdown

WorkstreamRevised Allocation
Surveys, site investigations, protection and mobilisation£1,200,000
Contractor pre-construction, procurement and limited enabling works£1,100,000
Planning-condition discharge and statutory submissions£500,000
Total£2,800,000

6.2 Surveys and Site Investigations — £1,200,000

The £1.2 million survey allowance is phased. Priority should be given to: measured and topographical surveys; utilities mapping; drainage and sewer surveys; title and boundary information; targeted ground investigations; contamination assessment; basement and foundation verification; noise, vibration and air-quality baselines; adjacent-building condition surveys; railway, TfL and highway-interface assessments; asset-protection requirements; and trial pits and opening-up where justified. Avoid duplicating work already included in the £50,000 ground-risk report or the data-centre technical package.

6.3 Contractor Pre-Construction & Procurement — £1,100,000

A Tier 1 contractor or appropriately experienced major-project contractor will be appointed through a Pre-Construction Services Agreement (PCSA). The £1.1 million allowance covers: PCSA services; constructability; logistics; programme; procurement; package tendering; long-lead planning; supply-chain engagement; early-works planning; and only limited, separately approved physical enabling works. Do not present the full £1.1 million as unrestricted construction expenditure. All principal enabling and construction works come under the build budget, not this Deployment & Project Mobilisation Budget.

6.4 Planning & Statutory Work — £500,000

This allocation covers: planning-condition discharge; Lambeth and GLA submissions; TfL approvals and asset-protection interfaces; highway and access approvals; building-control preparation; environmental-management submissions; construction logistics and traffic plans; utility consents; party-wall and neighbouring-rights work; and statutory submission fees.

Aerial view of Vauxhall Cross Island within the VNEB Opportunity Area.
The VNEB Opportunity Area — £15 billion of regeneration investment transforming Vauxhall and Nine Elms. PTAL 6b (highest transport rating in London).

7. Sardothien Project Delivery and Commercialisation Budget — £2.325M

7.1 Delivery Team Budget (Four-Month Allocation)

FunctionFour-Month Allocation
Executive leadership and programme-management office£450,000
Development and technical management£350,000
Finance, transaction and capital coordination£200,000
Procurement, document control and contract administration£150,000
Insurance, office, travel, stakeholder engagement and communications£225,000
Total delivery-team budget£1,375,000

7.2 Capital Formation & Exit Partnerships — £950,000

WorkstreamAllocation
Hotel, data-centre and commercial exit partnerships£550,000
Financial model, valuation, data room and investor/lender process£400,000
Total capital-formation and partnership budget£950,000

7.3 Partnership Budget Breakdown (£550,000)

Partnership ChannelAllocation
Data-centre operator, occupier and infrastructure-capital process£250,000
Hotel operator, brand and hotel-investor process£150,000
Office and retail leasing or forward-sale process£100,000
Residential branding and institutional-disposal work£50,000
Total£550,000

7.4 Sardothien Delivery Team Responsibilities

  • Maintaining the master programme and coordinating consultants
  • Managing scope and fee appointments; controlling project expenditure
  • Maintaining the design-responsibility matrix and risk/assumptions registers
  • Producing monthly investor reports and maintaining the data room
  • Coordinating the acquisition workstream and utility/authority engagement
  • Managing operator and exit-partner processes; coordinating contractor procurement
  • Certifying tranche conditions and escalating decisions to the project board

Expenditure will be supported by named personnel or contracted suppliers. Monthly expenditure will be reported. Material reallocations require approval. Reimbursable expenses will be capped. Services must not duplicate appointed consultant scopes.

Interior view of the hotel lobby and amenity space at Vauxhall Cross Island.
Hotel lobby and amenity space — the 500-key 5-star hotel occupies podium and lower tower levels. Exit-partnership process targeting operator MOU within Months 5–8.

8. Three-Tranche Release Programme

The capital will be released against milestones rather than equal calendar intervals. Each tranche is £5 million, controlled by defined gates that must be satisfied before release.

Tranche 1 — £5.000M | Financial Close and Immediate Mobilisation

UseAmount
Legal, transaction, structuring and acquisition advisory fees£2,700,000
Tax, KYC, AML and compliance£150,000
Business planning and appraisal£150,000
Historical introductory fee£500,000
Architecture, planning and engineering mobilisation£500,000
Data-centre technical mobilisation£250,000
Quantity-surveyor appointment£150,000
Sardothien PMO and delivery£250,000
Initial surveys, information review and site access£200,000
Financial model and data-room mobilisation£50,000
Initial protected buffer£100,000
Total£5,000,000

Conditions before release: MOU signed for the £200 million acquisition | Binding Initial Development Funding Agreement signed | KYC, AML and source-of-funds completed | Project vehicle and bank account established | £15 million budget approved | Site-access and information rights confirmed | Consultant appointment strategy approved | Project governance and reserved matters agreed | The £2.7 million legal fee payable only after binding funding documentation, legal close of the £15 million facility, KYC and source-of-funds completion, approved invoice and engagement documentation, Board approval, and satisfaction of all applicable completion conditions

Tranche 2 — £5.000M | Baseline Verification and Coordinated Development

UseAmount
Architecture, planning and engineering development£1,500,000
Data-centre technical investigations£1,050,000
Site investigations and protection works£650,000
Planning conditions and statutory submissions£200,000
Contractor PCSA and procurement£450,000
Sardothien PMO and delivery£500,000
Exit-partnership programme£200,000
Financial model, valuation and data room£200,000
Protected buffer£250,000
Total£5,000,000

Gate 1 requirements: Legal red-flag report issued | Corporate and acquisition structure mapped | Consultant appointments executed | Planning audit completed against the 2018 permission | Initial architectural test fit completed | Initial power and fibre strategy issued | Survey programme underway | QS baseline cost report issued | Business-plan assumptions register approved | Tranche 1 expenditure reported and reconciled

Tranche 3 — £5.000M | Coordinated Concept, Procurement and Investment Readiness

UseAmount
Provisional stamp-duty reserve£675,000
Architecture, planning and engineering completion£500,000
Data-centre technical completion£750,000
Site mobilisation and protection works£350,000
PCSA, procurement and limited enabling works£650,000
Planning conditions and statutory approvals£300,000
Sardothien PMO and delivery£625,000
Exit-partnership programme£350,000
Financial model and investor process£150,000
Protected project buffer£650,000
Total£5,000,000

Gate 2 requirements: Coordinated data-centre concept issued | Change-of-use planning route agreed in principle for lower-floor data centre | Power application or formal pre-application process commenced | Fibre route strategy completed | Ground and environmental results received | Updated cost plan issued | PCSA contractor selected or tender shortlist approved | Enabling-works package defined | Hotel, data-centre and commercial partner processes active | Month 4 completion forecast approved

Cross-Check of Workstream Totals Across All Tranches

WorkstreamTranche Total
Legal, transaction, tax and acquisition reserves£4.175M
Architecture, planning, engineering and QS£2.650M
Data-centre technical validation£2.050M
Site mobilisation, procurement and early works£2.800M
Sardothien project delivery and commercialisation£2.325M
Protected project buffer£1.000M
Overall Total£15.000M

Verified: Tranche 1 = £5.000M | Tranche 2 = £5.000M | Tranche 3 = £5.000M | Combined = £15.000M

9. Four-Month Delivery Programme

The four-month mobilisation period will produce: transaction and legal control; consultant mobilisation; planning and consent audit against the 2018 permission; initial RIBA Stage 2 coordination; data-centre feasibility; power and fibre applications; targeted surveys; QS cost plan; contractor PCSA procurement; statutory submissions; operator engagement; investor-readiness reporting; and lawful and limited site-enabling activity where properly authorised. Unrestricted principal construction cannot commence before: legal control of the site; required planning conditions discharged; Building Safety Regulator or building-control approval where applicable; construction funding; contractor appointment; insurance; utility approvals; third-party consents; and Board approval.

9.1 Weeks 1–2: Transaction Control & Mobilisation

  • Execute binding funding documentation for the £200 million MOU
  • Establish project governance and bank controls
  • Complete KYC, AML and tax mobilisation
  • Confirm site and data-room access
  • Appoint ZHA, Buro Happold, DP9 and QS workstreams
  • Mobilise project PMO; establish master programme, risk register and assumptions register
  • Issue survey instructions; commence business-plan and financial-model work

9.2 Weeks 3–6: Investigation & Baseline Verification

  • Complete legal and corporate red-flag review
  • Audit planning permission and conditions against the 2018 approval
  • Reconcile the approved scheme with the data-centre proposition
  • Complete architectural test fits; begin power and fibre feasibility work
  • Undertake targeted surveys and initial ground-risk assessment
  • Produce initial structural and MEP assessments
  • Issue QS baseline cost plan; commence authority and utility engagement
  • Prepare contractor procurement documents

9.3 Weeks 7–10: Coordinated Design & Procurement

  • Progress coordinated RIBA Stage 2 design
  • Confirm preferred data-centre operating model
  • Establish power and fibre connection strategy
  • Agree change-of-use planning submission route for lower-floor data centre
  • Issue PCSA tender; develop early-works and site-logistics packages
  • Launch controlled data-centre and hotel market engagement
  • Begin office and retail leasing strategy; update financial model

9.4 Weeks 11–16: Approvals, Early Works & Investment Readiness

  • Freeze coordinated concept for investor appraisal
  • Submit priority planning-condition and authority packages
  • Appoint preferred contractor under PCSA
  • Mobilise lawful site-establishment and protection works
  • Commence permissible enabling construction (under build budget)
  • Complete updated business plan and valuation
  • Issue power, fibre and data-centre feasibility report
  • Produce project execution plan; obtain partner expressions of interest
  • Submit Day-120 report to the investor and project board
Street-level view of the Vauxhall Cross Island towers.
Vauxhall Cross Island at street level — the towers anchor a £1.18B development programme with 1.2M sq ft GIA across two towers (52 and 46 storeys) connected by a 10-storey podium.

10. Construction Commencement Strategy

Planning permission for the site was approved in 2018. Construction and commercial partnership formation will proceed in parallel. Shell, core, surveys and enabling works may progress while partnerships are negotiated, but irreversible hotel layouts, specialist data-centre MEP procurement and operator-specific fit-out will not be frozen before the relevant operator requirements are substantially agreed. This avoids delay without creating expensive redesign or abortive procurement.

All enabling works come under the build budget, not the Deployment & Project Mobilisation Budget. The £15 million mobilisation budget covers only project-management allowances for surveys, investigations, site protection, PCSA services, procurement and statutory submissions.

Activities Targeted Within the First Four Months

Only lawful, reversible and separately authorised surveys, site-establishment, protection and limited enabling works may commence during the initial mobilisation period. The lower-floor change of use for the data centre can proceed under the existing 2018 consent while the change-of-use application is progressed in parallel.

  • Site establishment, security, hoarding and welfare
  • Surveys and monitoring; trial pits and opening-up works
  • Ground and contamination investigations
  • Utilities investigations and diversions planning
  • Asset-protection measures and temporary works design
  • Demolition or clearance where lawfully authorised
  • Contractor PCSA activity and long-lead procurement planning
  • Planning-condition discharge and early enabling works (under build budget)

Activities Subject to Further Approvals

Unrestricted principal construction cannot commence before: legal control of the site; required planning conditions discharged; Building Safety Regulator or building-control approval where applicable; construction funding; contractor appointment; insurance; utility approvals; third-party consents; and Board approval. However, the lower-floor change of use for the data centre can proceed under the existing 2018 consent while the change-of-use application is progressed. Principal building work is therefore able to commence before the following are fully satisfied, subject to the data-centre-specific items being resolved before in-scope lower-floor work begins:

  • Legal control of the site
  • Relevant conditions discharged
  • Construction funding and contractor appointment
  • Insurance | Approved construction-management and logistics plans
  • Utility and third-party consents
  • Board-approved target cost and risk allocation

11. Months 5–8 Partnership-Completion Programme

PeriodData CentreHotelOffice & Retail
Month 5Technical brief and operator workshopsOperator/brand RFP strategyLeasing and occupier strategy
Month 6Site, grid and fibre due diligenceBrand technical reviewAnchor-tenant engagement
Month 7Commercial bids and terms sheetsManagement/franchise/lease termsPre-let and forward-purchase proposals
Month 8Preferred partner and heads of termsPreferred operator and heads of termsPreferred leasing and exit route

Target Month 8 Outputs

  • Preferred data-centre operator, occupier or capital partner with MOU, LOI or term sheet
  • Preferred hotel operator or brand with heads of terms
  • Office and retail leasing strategy with commercial anchor-tenant pipeline
  • Forward-funding and sale options incorporated into the financial model
  • Operator requirements incorporated into Stage 3 design
Ground-level public plaza at the base of Vauxhall Cross Island.
Public realm at podium level — retail, landscaping, and pedestrian connectivity between Wandsworth Road and the Vauxhall transport interchange. 100,000 sq ft of retail and office space.

12. Governance & Investor Controls

12.1 Project Bank Account

All £15 million will be paid into a dedicated project account. Payments will require: approved budget code | valid contract or appointment | invoice | workstream-owner approval | finance approval | project-director certification | independent QS certification for works where appropriate.

12.2 Spending Authority

CommitmentApproval Required
Up to £25,000 (within budget)Workstream director and finance
£25,001–£100,000Project director and finance director
£100,001–£500,000Board
Above £500,000Project board / investor approval
Any unbudgeted related-party paymentProject board / investor approval
Any use of the £1M bufferBoard plus investor representative

13. Protected £1 Million Buffer

The £1 million Protected Project Buffer is ring-fenced; not automatically spendable; released only for documented project risks or unforeseen requirements; subject to approval under the agreed governance structure; and reported separately in each investor expenditure report. It is not general working capital. It may only be used for:

  • Unforeseen legal or acquisition issues
  • Additional planning or environmental evidence
  • Survey discoveries
  • Utility application or security payments
  • Urgent site-protection works
  • Building-safety requirements
  • Critical consultant scope omitted from an appointment
  • Programme-protection measures approved by the Board

Buffer Release Authority: Any use of the £1 million buffer requires Board approval. This is the highest level of spending authority and ensures the buffer is preserved for genuine contingencies only.

14. Day-120 Completion Criteria

The four-month programme will be regarded as successful when the following have been delivered:

  1. Binding investor and funding documentation
  2. Verified acquisition and corporate structure
  3. Written UK/Jersey tax opinion
  4. Planning-permission and conditions report against the 2018 approval
  5. Coordinated architectural repurposing concept
  6. Data-centre technical feasibility report
  7. Formal power and fibre pathway
  8. Updated ground, contamination and basement report
  9. Structural and MEP integration report
  10. Updated QS cost plan
  11. Procurement and contractor strategy
  12. PCSA appointment or completed tender process
  13. Early-works package and lawful commencement plan
  14. Updated business plan and financial model
  15. Hotel, data-centre and commercial exit-partner pipeline
  16. At least preliminary written interest from credible counterparties
  17. Master project programme
  18. Updated risk register
  19. Full £15 million expenditure and commitment report
  20. Conditions schedule for release of the remaining £185 million

15. Project Team

The following companies and consultants form the Vauxhall Cross Island professional team:

Site Owner and Developer

VCI Property Holding Limited
PO Box 1075
Elizabeth House, 9 Castle Street
St. Helen, Jersey
Channel Islands, JE4 2QP

Development Manager

Great Malborough Estates
11 Bruton Street
London, W1J 6PY
T: 020 7518 7818

Architect

Zaha Hadid Architects
10 Bowling Green Lane
London, EC1R 0BQ
T: 020 7253 5147

Landscape Architect

Townshend Landscape Architects
1E Zetland House
5-25 Scrutton Street
London, EC2A 4HJ
T: 020 7729 9333

Structural, Services, Access, Security & Transport

Buro Happold
17 Newman Street
London, W1T 1PD
T: 020 7927 9700

Cost Consultant

Core Five
230 Blackfriars Road
London SE1 8NW
T: 020 3141 5555

Building Control

Approved Inspector Services
14 Berkeley Street
London, W1J 8DX
T: 020 7491 1914

Town Planning Consultant

DP9
100 Pall Mall
London, SW1Y 5NQ
T: 020 7004 1700

Townscape Consultant

Tavernor Consultancy
85 Southwark Street
London, SE1 0HX
T: 020 7921 0123

Townscape Consultant

Miller Hare
Mappin House
4 Winsley Street
London W1W 8HF
T: 020 7691 1000

Public Consultation Consultant

Kanda Consulting
69-85 Tabernacle Street
London, EC2A 4BD
T: 020 3900 3676

Daylight, Sunlight & Right to Light

GIA
The Whitehouse
Belvedere Road
London, SE1 8GA
T: 020 7202 1400

16. Project-Management Recommendation

The £15 million Initial Development and Project Mobilisation Budget will be deployed as a controlled project-development programme rather than as a single unrestricted professional-fee payment. The recommended release sequence is:

£5 million at binding financial close£5 million after legal, planning and technical baseline verification£5 million after coordinated design, procurement and early-works readiness

This structure gives the investor measurable control while allowing Sardothien to move quickly enough to: protect the opportunity | modernise the 2017 scheme against the 2018 planning permission | validate the data-centre proposition for lower-floor repurposing | begin site and construction mobilisation | build credible exits | prepare the project for the remaining £185 million of acquisition-stage funding.

The principal strategic rule: No cost is incurred merely to produce activity. Every expenditure must advance acquisition control, planning certainty, technical bankability, construction commencement, capital release or a credible asset exit. All enabling works come under the build budget, not the Deployment & Project Mobilisation Budget.

£15M
Initial Mobilisation Budget
3
Milestone-Controlled Tranches
120
Days to Completion
20
Completion Criteria
£1M
Protected Buffer
£185M
Subsequent Capital Release
Close-up of the Vauxhall Cross Island tower facade with the Thames and London skyline.
The Vauxhall Cross Island towers — 185m and 151m of landmark architecture by Zaha Hadid Architects, with the Thames, Palace of Westminster and London Eye visible across the river.
